Beginning on or around September 10th and continuing through mid-October, cable laying operations for the inter-array cables will be conducted, beginning with array cable lines five and six.

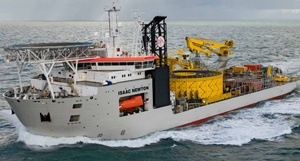

The Cable Laying Vessel Isaac Newton will be conducting cable laying operations for the inter-array cables and will remain on-site until early October. The C-Pioneer will be acting as a stationary support vessel, supporting cable pulling activities for the inter-array cables. The Trenching Support Vessel Adhemar De Saint-Venant will be performing cable trenching, burial works. The F/V Seafarer will be operating around the activities as a safety vessel to monitor traffic and facilitate safe movement of fishing vessels, recreational craft, or other transiting vessels around the work sites and project vessels.
