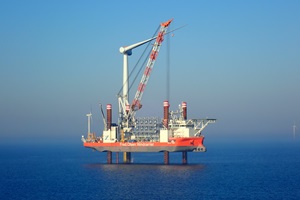

Fred. Olsen Windcarrier’s jack-up installation vessel Bold Tern successfully installed turbine number 91 on Hornsea One offshore wind farm on 25 September 2019. This marked the end of the project for Bold Tern.
Installation of the Siemens Gamesa SWT-7.0-154 turbines began 5 February 2019 and have been installed in tandem by Bold Tern and DEME’s Sea Challenger. Hornsea One consists of a total of 174 turbines and the site is approximately 120 km off the Yorkshire coast.
